Nearly 50% of work hours are consumed by "work about work" - tasks that don’t move the needle. This guide provides copy-paste templates, step-by-step workflows, freemium tools, and data-backed strategies to eliminate up to 40% of this waste immediately and streamline processes.

What is a streamlined process?

A streamlined process eliminates unnecessary steps, reduces handoffs, and automates routine decisions to achieve the same outcome faster and with less effort.

So to explain it using real-world example, consider this:

Before streamlining example: Request → Email → Meeting → Discussion → Another Meeting → Email Thread → Approval → Implementation (8 steps, 3 days)

After streamlining example: Request → Auto-approval via template → Implementation (2 steps, 30 minutes)

💡
Shopify CEO Tobi Lütke reportedly implemented a "No Meeting Wednesday" policy to reduce unnecessary meetings and adopted asynchronous decision-making templates. This approach led to a 25% increase in shipping speed.

Importance of streamlined processes

  • Cost impact: Organizations with mostly manual, paper-based workflows lose $1.3 million annually from inefficient processes.
  • Time waste: 2.5 hours daily, or roughly 30% of the workday, spent searching for critical information.
2.5 hours daily, or roughly 30% of the workday, spent searching for critical information
  • Revenue loss: IDC research cited by Entrepreneur states companies lose 20 to 30 percent in revenue every year due to inefficiencies.
  • Productivity drain: 64% of sales rep time spent on non-revenue activities.
  • Reduced workforce satisfaction: Process inefficiencies drive employee turnover costs and reduce workforce satisfaction, creating compounding talent retention expenses.
  • Business risk: Poor processes increase compliance violations and delay critical decisions, resulting in missed market opportunities and regulatory penalties.

The cost of inefficiency: 2025 benchmarks

  • Recent data shows invoice processing costs range from $1.77 for top performers to $10.89 for bottom performers, and automation typically cuts costs by 60-80%.
  • Companies with non-streamlined processes resolve tickets 67% slower.
  • The average employee spends a third of their shift on performative work rather than productive activities.

How to streamline a process: 8 expert tips

Streamlining a process involves identifying bottlenecks, automating repetitive tasks, and generating workflows for greater efficiency.

1. Track tasks with the right tool stack

Copy this tool selection framework:

Step 1: List your team's top 5 daily activities
Step 2: Map each activity to tool requirements
Step 3: Test one tool for 7 days
Step 4: Measure: Time saved vs. Learning curve
Step 5: Adopt or iterate

Use this exact tool-team matrix:

Team Type Process Being Streamlined Primary Tool Integration Stack Implementation Time
Engineering Sprint planning, bug tracking, feature development workflow, code review coordination Linear GitHub + Slack + Figma 2 days
Marketing Campaign management, content calendar, lead qualification, performance tracking and reporting Asana, Supademo HubSpot + Canva + Analytics 3 days
Sales Lead management, opportunity tracking, proposal generation, follow-up automation Monday.com, Supademo CRM + Email + Calendar 1 day
Operations Documentation management, vendor onboarding, inventory tracking, compliance workflows Notion, Supademo Zapier + Forms + Database 5 days
Customer Success Onboarding automation, support ticket routing, customer health scoring, retention workflows Supademo Help desk + CRM + Analytics 1 day

2. Create clear and measurable goals using templates

a. Eisenhower Matrix template:

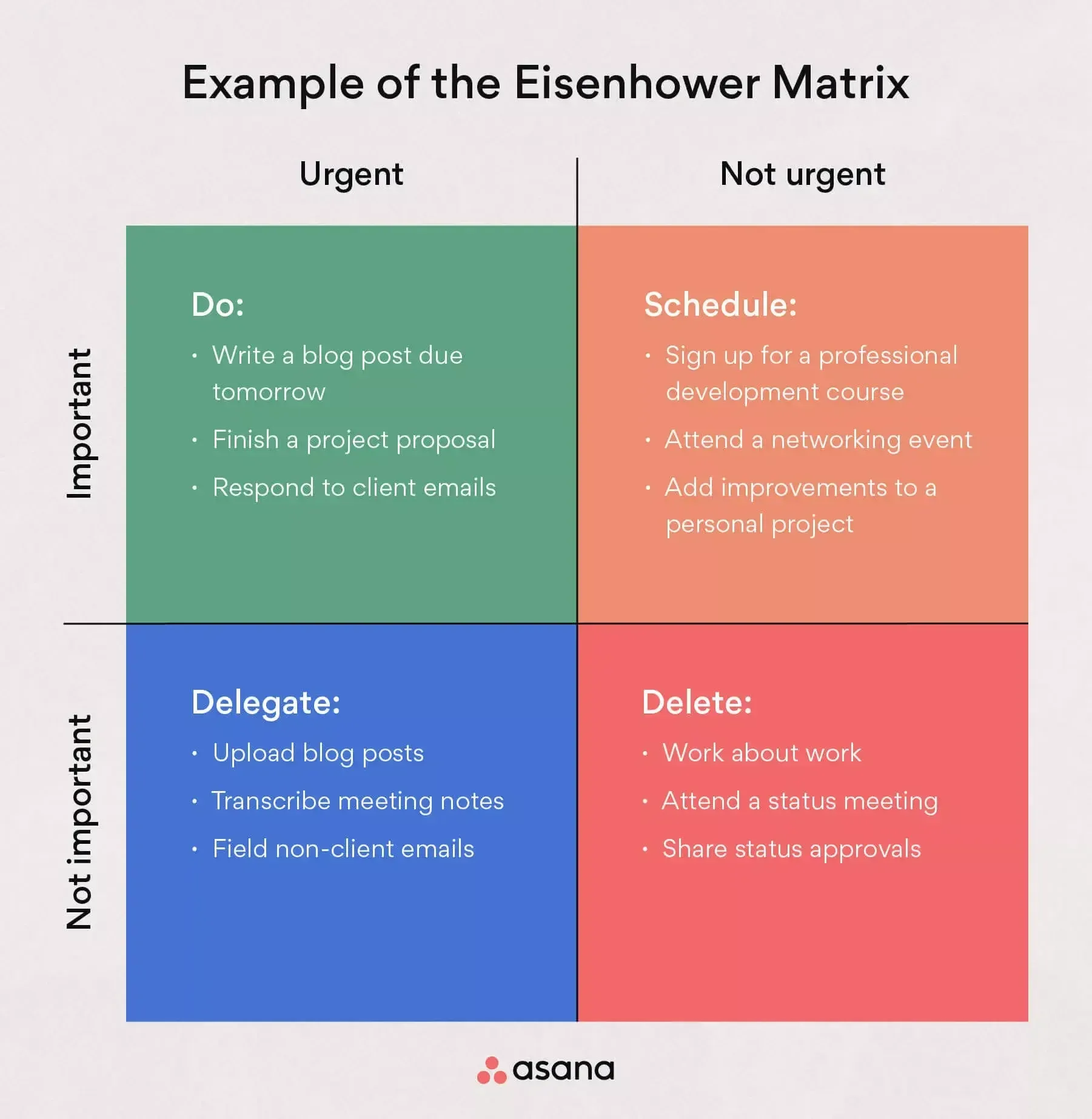

An Eisenhower Matrix template visually sorts tasks by urgency and importance, helping you divide your tasks into four categories: the tasks you’ll do first, the tasks you’ll schedule for later, the tasks you’ll delegate, and the tasks you’ll delete.

Build your Eisenhower Matrix with Asana
Source: Asana

b. OKR template:

An Objectives and Key Results (OKR) tracker is a tool for aligning team efforts and tracking progress towards critical goals. Check out these free OKR tracker templates available on Notion to help make it easier.

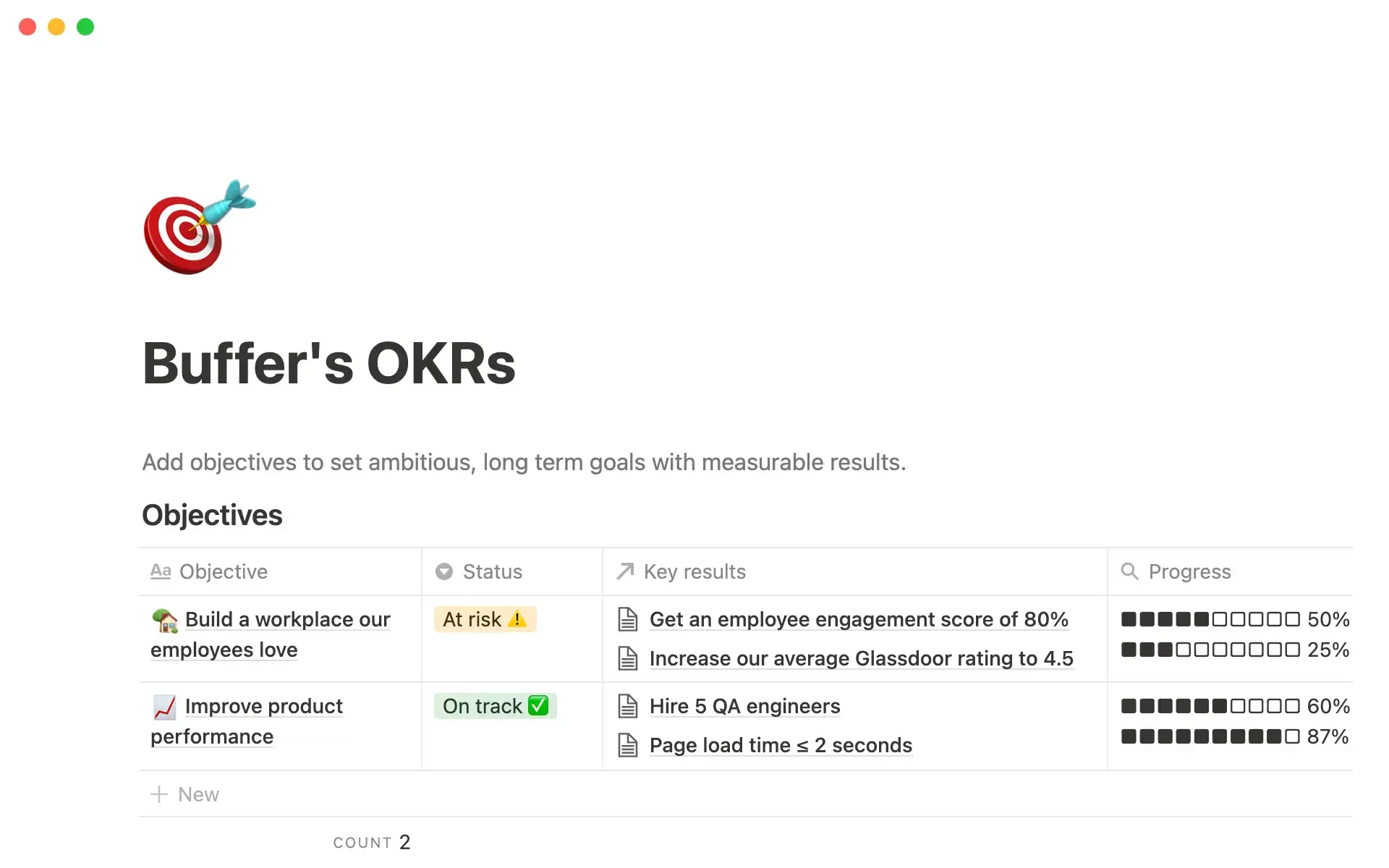

Use Notion's free OKR template
Source: Use Notion's free OKR template

3. Build an open knowledge repository

Maintain an organised, central repository for anyone in your team to access. Notion's intuitive wiki template facilitates seamless teamwork to build an internal company hub. All structured in a clean and pre-built dashboard with key sections like SOPs, how we work, company updates, and essential brand resources.

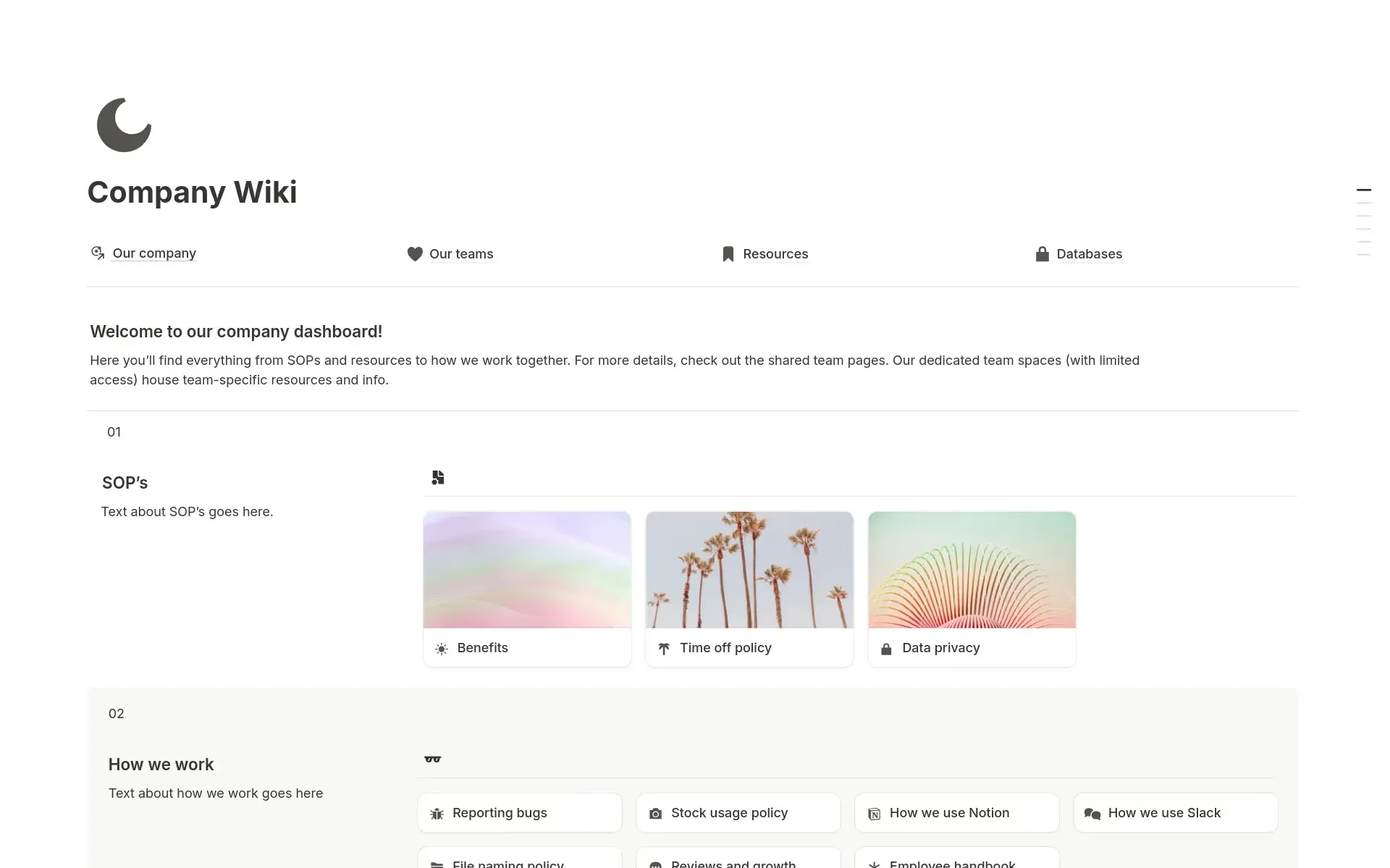

Notion's wiki template
Source: Notion's wiki template

Supademo helps create interactive product demos and guides that can be embedded in traditional text-based knowledge repositories to make process documentation more visual, engaging and effective.

Instead of having just text-based SOPs and process documentation in Notion's wiki template, Supademo allows teams to:

  • Create self-paced product tours
  • Visually communicate products and processes
  • Simulate UI, flows, and interactions from real software without writing code

4. Automate as much as possible (the 5-minute rule)

Automation decision tree:

Is this task repeated more than 3x per week?
├── YES → Does it take less than 5 minutes each time?
│   ├── YES → Automate it
│   └── NO → Document it first, then automate
└── NO → Keep manual for now

Here are some ready-to-use automation recipes:

Recipe 1: Email to task automation

  • Tool: Zapier + Gmail + Asana
  • Trigger: Email with specific label
  • Action: Create Asana task with email content
  • Setup time: 10 minutes
  • Time saved: 2 hours/week

Recipe 2: Client onboarding sequence

  • Tool: Supademo + Zapier + CRM
  • Trigger: New client added to CRM
  • Actions:
    1. End welcome email with interactive demo
    2. Create onboarding checklist
    3. Schedule follow-up calls
    4. Add to Slack channel
  • Setup time: 30 minutes
  • Time saved: 5 hours per client

Recipe 3: Social media content pipeline

  • Tool: n8n workflow with OpenAI + Google Sheets + LinkedIn
  • Process: Content ideas → AI generation → Approval → Scheduled posting
  • Setup: Use this free template from n8n community
  • Time saved: 10 hours/week

5. Create self-serve learning systems

The 2-minute rule for documentation:If someone asks the same question twice, create a 2-minute demo immediately.

Interactive demo creation checklist:

☐ Record the process end-to-end
☐ Add click hotspots at decision points
☐ Include "Why we do this" explanations
☐ Add troubleshooting for common errors
☐ Test with someone unfamiliar with process
☐ Embed in searchable knowledge base
☐ Track completion rates and drop-off points

Supademo's process documentation generator:

  1. Scenario setup: "You're onboarding a new client..."
  2. Step-by-step navigation: Click here → Then here → Now this
  3. Context bubbles: Explain why each step matters
  4. Decision points: "If X, do Y. If Z, do A."
  5. Success criteria: "You'll know it worked when..."

6. Implement time-sensitive workflows

The 40-40-20 time allocation rule:

  • 40% Planning and setup
  • 40% Execution
  • 20% Buffer for unexpected issues

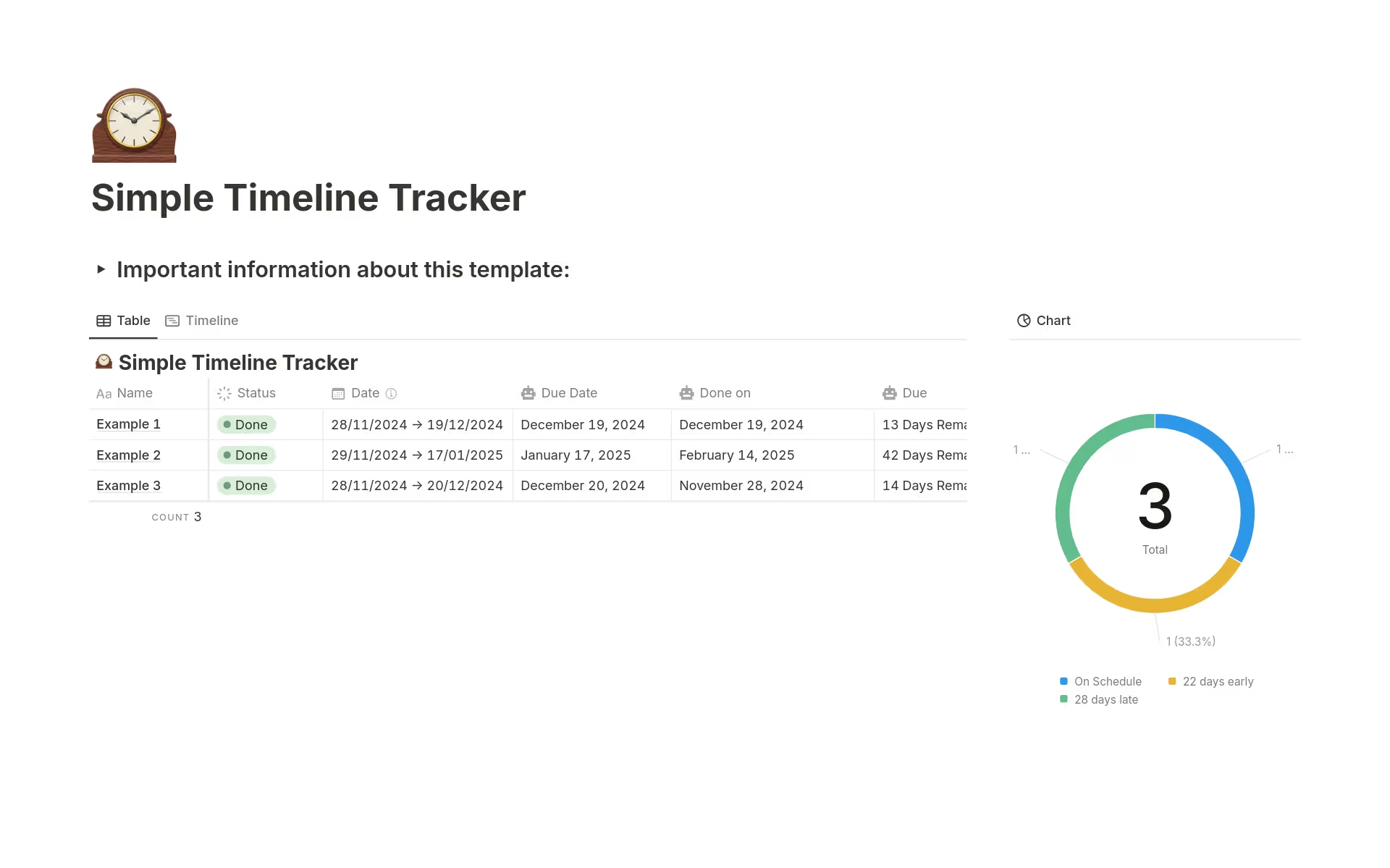

You can use Notion's deadline management template to keep track of project deadlines.

Notion's deadline management template
Source: Notion's deadline management template

7. Standardize with templates

Template creation methodology:

  1. Document your best performer's process
  2. Convert to step-by-step checklist
  3. Test with average performer
  4. Refine based on results
  5. Make it the standard

Meeting templates that actually work:

8. Enable open communication through systems

Here's a communication protocol that establishes clear expectations and channels for different types of workplace interactions:

  • For informational messages that don't require any response, use email or Slack with "[FYI]" in the subject line, allowing team members to stay informed without feeling pressured to reply.
  • When you need input from colleagues, use Slack mentions with the "[INPUT]" tag followed by a clear deadline, expecting responses within 24 hours to keep projects moving forward.
  • Decision-required communications should use both Slack and email channels with the "[DECISION]" tag plus relevant context, with a 4-hour response expectation to prevent bottlenecks in critical choices.
  • For truly urgent matters, escalate to phone calls or text messages using the "[URGENT]" tag along with a brief explanation of why immediate attention is needed.

Finally, maintain regular project visibility through weekly status update emails using a standard template format, creating predictable communication rhythms that keep everyone aligned.

Slack channel organization:

#general - Company announcements
#random - Non-work conversations
#help-[tool] - Tool-specific questions
#project-[name] - Active project discussions
#team-[department] - Department-specific chat
#wins - Celebrating successes
#process-improvements - Workflow suggestions

8 methodologies for streamlining business processes

1. Lean Six Sigma

When to use: High-volume, repetitive processes with quality issues
Timeline: 3-6 months per project
Expected ROI: 15-25% efficiency gain

DMAIC implementation template:

D - Define Phase (Week 1-2):
☐ Problem statement: [Specific issue]
☐ Goal statement: [Measurable target]
☐ Process boundaries: [Start/end points]
☐ Customer requirements: [What they need]
☐ Project charter approval

M - Measure Phase (Week 3-4):
☐ Current state process map
☐ Data collection plan
☐ Baseline metrics established
☐ Measurement system validation
☐ Capability study completed

A - Analyze Phase (Week 5-8):
☐ Root cause analysis (5 Whys + Fishbone)
☐ Data analysis completed
☐ Hypothesis testing
☐ Vital few causes identified
☐ Quick wins implemented

I - Improve Phase (Week 9-12):
☐ Solution brainstorming sessions
☐ Pilot implementation
☐ Results validation
☐ Risk assessment completed
☐ Full rollout plan

C - Control Phase (Week 13-16):
☐ Control plan created
☐ Monitoring systems in place
☐ Training materials developed
☐ Process documentation updated
☐ Project closure and handoff

You can access free Lean Six Sigma tools here.

2. Agile

When to use: Projects with changing requirements, creative work
Timeline: 2-4 week sprints
Expected ROI: 30% faster delivery, 40% better quality

Agile sprint template:

Sprint Duration: 2 weeks | Team: [Names] | Sprint Goal: [Objective]

Sprint Planning (2 hours):
☐ Review product backlog
☐ Select sprint backlog items
☐ Break down user stories into tasks
☐ Estimate effort (story points)
☐ Commit to sprint goal

Daily Standups (15 minutes):
Format: What did you do? What will you do? Any blockers?
☐ Monday standup completed
☐ Tuesday standup completed
☐ Wednesday standup completed
☐ Thursday standup completed
☐ Friday standup completed

Sprint Review (1 hour):
☐ Demo completed features
☐ Gather stakeholder feedback
☐ Update product backlog
☐ Calculate team velocity

Sprint Retrospective (1 hour):
☐ What went well?
☐ What could be improved?
☐ Action items for next sprint
☐ Team agreements updated

Agile tools setup:

  • Jira/Linear for backlog management
  • Slack for daily communication
  • Confluence/Notion for documentation

3. Kaizen

When to use: Cultural change, ongoing optimization
Timeline: Ongoing (weekly improvements)
Expected ROI: 5-10% continuous improvement

Kaizen event template (5-day format):

Day 1: Current State Analysis
☐ Process walkthrough
☐ Time and motion study
☐ Waste identification (7 wastes)
☐ Data collection
☐ Problem prioritization

Day 2: Future State Design
☐ Brainstorm improvements
☐ Create future state map
☐ Calculate potential benefits
☐ Risk assessment
☐ Resource planning

Day 3: Implementation Planning
☐ Action plan creation
☐ Assign responsibilities
☐ Timeline development
☐ Training requirements
☐ Communication plan

Day 4: Pilot Implementation
☐ Execute quick wins
☐ Test new processes
☐ Collect feedback
☐ Make adjustments
☐ Document changes

Day 5: Standardization
☐ Create standard work
☐ Update documentation
☐ Train all team members
☐ Set up monitoring
☐ Plan follow-up

Weekly Kaizen checklist:

☐ One small improvement identified
☐ Solution brainstormed with team
☐ Test conducted (max 1 day)
☐ Results measured
☐ Implement if positive, iterate if not
☐ Document learning
☐ Share with other teams

4. Business Process Reengineering (BPR)

When to use: Broken processes requiring complete overhaul
Timeline: 6-12 months
Expected ROI: 50-70% process improvement

BPR implementation framework:

Phase 1: Vision and Objectives (Month 1)
☐ Executive sponsorship secured
☐ BPR team assembled
☐ Vision statement created
☐ Success metrics defined
☐ Change management plan

Phase 2: Process Understanding (Month 2-3)
☐ Current process documented
☐ Performance baseline established
☐ Pain points identified
☐ Customer requirements mapped
☐ Technology assessment

Phase 3: Process Redesign (Month 4-6)
☐ Clean slate approach applied
☐ New process designed
☐ Technology solutions identified
☐ Organizational changes planned
☐ Risk mitigation strategies

Phase 4: Implementation (Month 7-10)
☐ Pilot program launched
☐ Training delivered
☐ Technology deployed
☐ Performance monitored
☐ Adjustments made

Phase 5: Continuous Improvement (Month 11-12)
☐ Full rollout completed
☐ Benefits realized
☐ Lessons learned documented
☐ Ongoing improvement process
☐ Project closure

5. Total Quality Management (TQM)

When to use: Customer success is priority, strong leadership support
Timeline: 12-24 months for full implementation
Expected ROI: 20-30% customer satisfaction improvement

TQM implementation roadmap:

Foundation Building (Months 1-3):
☐ Leadership commitment demonstrated
☐ Quality policy established
☐ Employee training programs
☐ Customer feedback systems
☐ Supplier quality agreements

Process Implementation (Months 4-9):
☐ Statistical process control
☐ Continuous improvement teams
☐ Quality circles established
☐ Benchmarking activities
☐ Employee empowerment programs

Results and Review (Months 10-12):
☐ Performance measurement systems
☐ Customer satisfaction surveys
☐ Quality cost analysis
☐ Recognition and reward systems
☐ Annual quality reviews

6. Theory of Constraints (TOC)

When to use: Clear bottlenecks limiting overall performance
Timeline: 1-3 months per constraint
Expected ROI: 25-40% throughput improvement

TOC five-step process:

Step 1: Identify the Constraint
☐ Map the entire process flow
☐ Measure capacity at each step
☐ Calculate utilization rates
☐ Identify the bottleneck
☐ Validate with data

Step 2: Exploit the Constraint
☐ Maximize constraint utilization
☐ Eliminate downtime/breaks
☐ Improve quality at constraint
☐ Add skilled operators
☐ Implement quick fixes

Step 3: Subordinate Everything Else
☐ Align upstream processes
☐ Control WIP levels
☐ Adjust schedules
☐ Modify non-constraint operations
☐ Buffer management

Step 4: Elevate the Constraint
☐ Add capacity (people/equipment)
☐ Improve technology
☐ Redesign process
☐ Outsource if needed
☐ Capital investment

Step 5: Return to Step 1
☐ Identify new constraint
☐ Avoid policy constraints
☐ Continuous improvement
☐ Monitor performance
☐ Repeat cycle

7. Value Stream Mapping (VSM)

When to use: Complex workflows with multiple handoffs
Timeline: 1-2 months per value stream
Expected ROI: 20-30% waste reduction

VSM workshop template (3-day format):

Day 1: Current State Mapping
☐ Define value stream boundaries
☐ Walk the process physically
☐ Map information flow
☐ Map material flow
☐ Collect process data
☐ Identify waste (8 types)
☐ Calculate lead time vs. value-add time

Day 2: Future State Design
☐ Apply lean principles
☐ Design future state map
☐ Calculate improvements
☐ Identify enabling changes
☐ Create implementation plan

Day 3: Action Planning
☐ Prioritize improvements
☐ Assign owners
☐ Set timelines
☐ Define metrics
☐ Plan follow-up sessions

VSM data collection sheet:

Process Step: [Name]
├── Cycle Time: [Minutes]
├── Lead Time: [Hours/Days]
├── % Complete & Accurate: [%]
├── Number of People: [Count]
├── Working Hours: [Hours/day]
├── Batch Size: [Units]
├── Changeover Time: [Minutes]
└── Uptime: [%]

8. Balanced scorecard

When to use: Aligning processes with strategic objectives
Timeline: 3-6 months to implement
Expected ROI: 15-25% strategic goal achievement

Balanced scorecard template:

Financial Perspective:
├── Revenue Growth: [Target %]
├── Cost Reduction: [Target $]
├── ROI: [Target %]
└── Cash Flow: [Target $]

Customer Perspective:
├── Customer Satisfaction: [Target score]
├── Customer Retention: [Target %]
├── Market Share: [Target %]
└── On-time Delivery: [Target %]

Internal Process Perspective:
├── Process Efficiency: [Target %]
├── Quality Metrics: [Target defect rate]
├── Innovation Rate: [Target # new processes]
└── Compliance Score: [Target %]

Learning & Growth Perspective:
├── Employee Satisfaction: [Target score]
├── Training Hours: [Target hours/employee]
├── Skills Assessment: [Target score]
└── Knowledge Sharing: [Target # sessions]

Methodology selection decision tree

Is your process fundamentally broken?
├── YES → Use BPR (Business Process Reengineering)
└── NO → Is there a clear bottleneck?
    ├── YES → Use TOC (Theory of Constraints)
    └── NO → Do you need cultural change?
        ├── YES → Use Kaizen + TQM
        └── NO → Is this a complex workflow?
            ├── YES → Use VSM (Value Stream Mapping)
            └── NO → Do you need strategic alignment?
                ├── YES → Use Balanced Scorecard
                └── NO → Use Lean Six Sigma or Agile

Tools to help streamline processes

I'm aligned with Fredo Tan's less is more theory.

Here are some of my personal favourite tool suggestions -

Tool Use Case Setup Guide Free Resources
Notion Knowledge base + tasks Free workflow templates 100+ free templates
Zapier Automation 7000+ ready templates Free tier: 5 workflows
Supademo Interactive documentation Record → Edit → Share Free plan available
Slack Communication Channels + integrations setup Free for small teams
Linear/Asana Task management Import from existing tools Free starter plans

Tool integration checklist:

☐ Single sign-on (SSO) configured
☐ Data flows between tools automatically
☐ Notifications consolidated (not duplicated)
☐ Reporting pulls from all systems
☐ Backup/export options confirmed
☐ Team trained on integrations
☐ Performance monitored weekly

Streamline processes today with Supademo

The companies dominating 2025 aren't necessarily the smartest—they're the most efficient. Every minute you save on "work about work" is a minute you can spend on work that matters.

Ready to streamline processes? Pick one template from this playbook and implement it today. Then try Supademo for free to transform your process documentation from static guides into engaging, trackable experiences that actually get used.
